A concrete block machine’s rated output is only one part of a factory’s production capacity. If the mixer cannot supply concrete fast enough, pallets are unavailable, or the curing area is full, the line may stop even when the main machine is ready to run.
For manufacturers in Kazakhstan, Uzbekistan, and other Central Asian markets, planning should connect forming capacity, concrete supply, pallet circulation, curing, and finished-product storage. This helps identify bottlenecks before equipment is ordered.

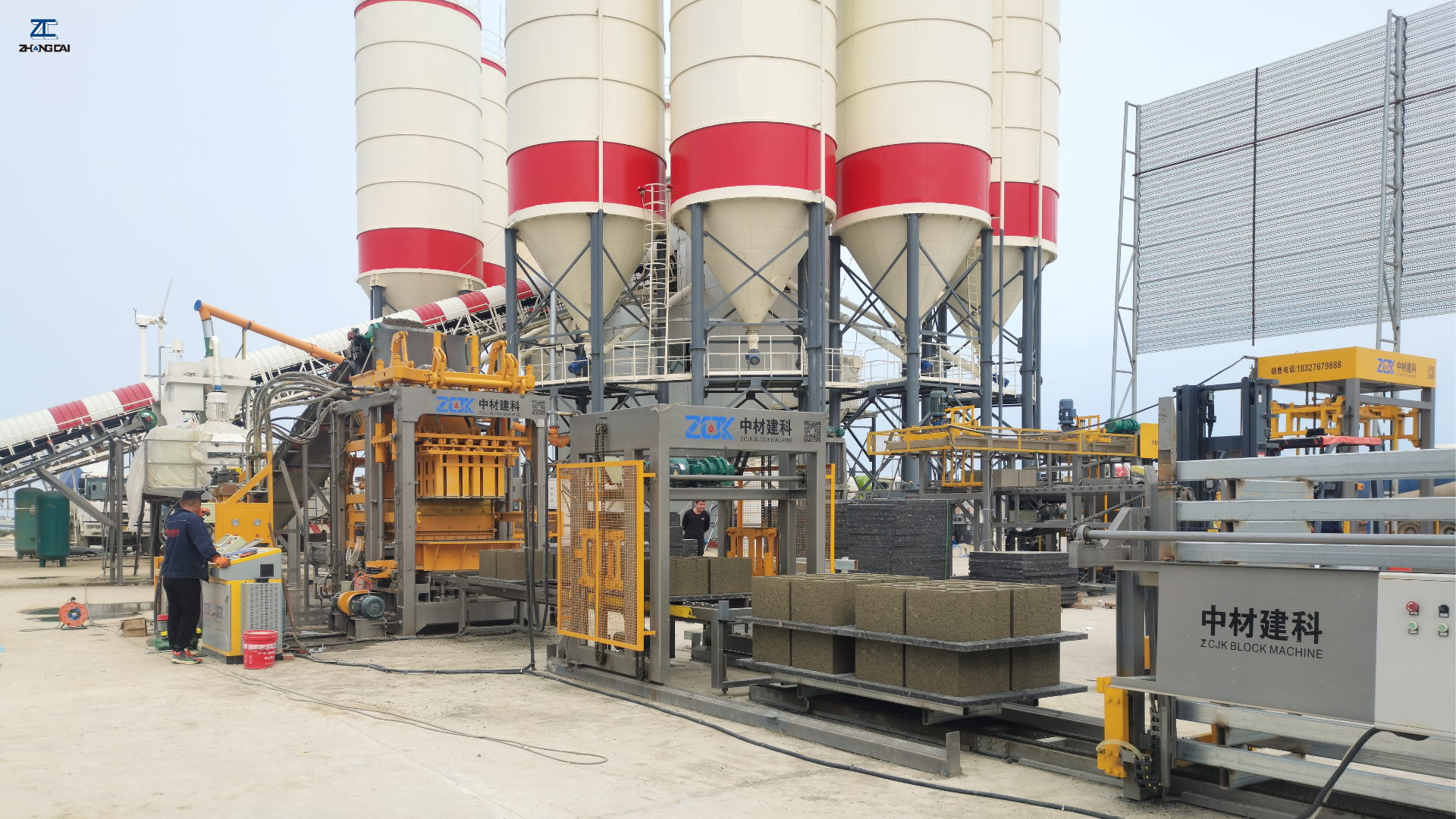

A typical line includes batching and mixing, block forming, green-block handling, curing, and finished-product storage. Its sustainable output is limited by the slowest or least available stage.
A fast machine may wait for concrete if mixing is too slow; full curing racks can prevent fresh blocks from being transferred. Poor forklift routes can also obstruct production or damage blocks.
Treat the plant as one system. Map the movement of concrete, pallets, green blocks, and finished products to identify likely queues.
List the intended products, dimensions, quality requirements, daily demand, shifts, and mold-change frequency. These factors affect units per cycle and concrete demand.
A first estimate of theoretical output is:
Theoretical output per shift = Blocks per cycle × Cycles per hour × Productive hours
Cycles per hour = 3,600 ÷ Cycle time in seconds
For example, a hypothetical setup producing six blocks per cycle with a 20-second cycle time and seven productive hours would yield:
6 × (3,600 ÷ 20) × 7 = 7,560 blocks per shift.
This is an illustration, not a ZCJK machine specification or a guaranteed result.
Actual output depends on mold configuration, product size, mix consistency, changeovers, maintenance, operators, and downstream availability. Use realistic productive time and saleable output, then calculate the load placed on the mixer, pallet loop, curing area, and handling equipment.

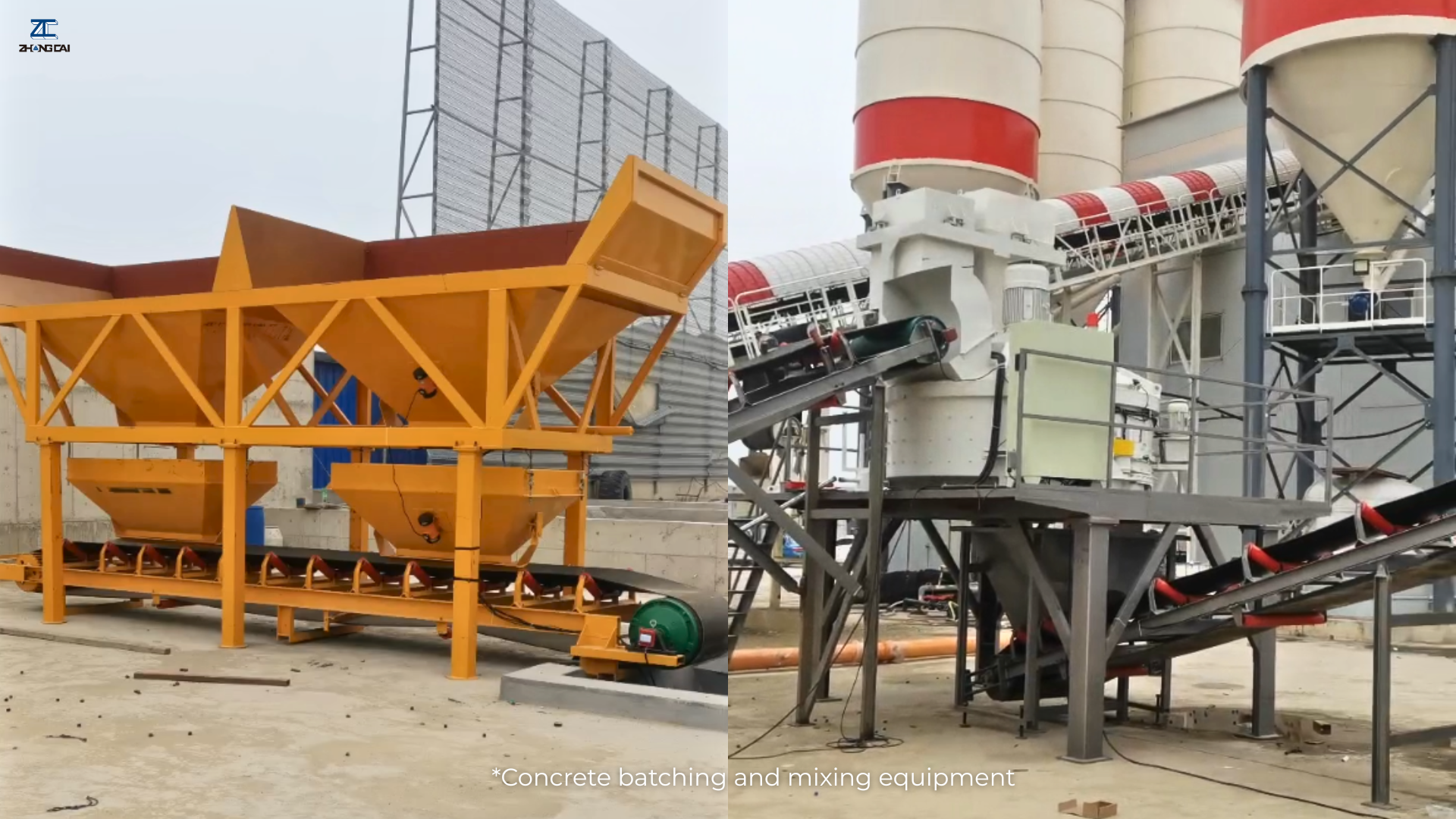

The mixing system must deliver a consistent supply of concrete at the rate the forming machine consumes it. Compare the machine’s concrete demand with the mixer’s effective output, rather than choosing a mixer by model number or nominal batch size alone.
Use these estimates:
Concrete demand per hour = Blocks required per hour × Actual concrete volume per block
Theoretical mixer output per hour = Net discharge volume per batch × Completed batches per hour
Use actual consumption from the product design and trials; a hollow block’s external dimensions do not equal its concrete volume. Count the full loading, mixing, discharge, and delivery cycle—not mixing time alone.
Check peak demand, too: a mixer may meet average daily demand yet interrupt production during busy periods. The transfer system must also keep pace.
ZCJK’s Concrete Mixer Capacity Guide explains feeding capacity, discharge capacity, rated productivity, and cycle time. The National Precast Concrete Association’s batching and mixing guidance also recommends matching equipment to production needs and operating conditions.
Production pallets connect block forming with curing and must circulate back to the machine without delay. If too few pallets are available—or if transfer, unloading, cleaning, or return takes too long—the forming machine may sit idle.
Estimate daily pallet loads as follows:
Pallet loads per day = Daily block output ÷ Blocks per pallet
For example, 12,000 blocks per day at six blocks per pallet require 2,000 pallet loads per day. Total pallet demand depends on how long each pallet remains occupied through forming, transfer, curing, unloading, and return. Estimate pallets tied up in a stage with:
Pallet positions required = Pallet loads entering per day × Residence time in days
Refine the estimate using actual handling times and curing methods, with allowances for damage, maintenance, and operating variation.
Freshly formed blocks, often called green blocks, need stable support and careful transfer. Sudden impact, vibration, or poorly aligned handling equipment can damage edges and increase rejects. Review pallet feeding, conveyors, transfer equipment, and the route into curing as one workflow. See ZCJK’s guide to automatic pallet feeders for related equipment considerations.

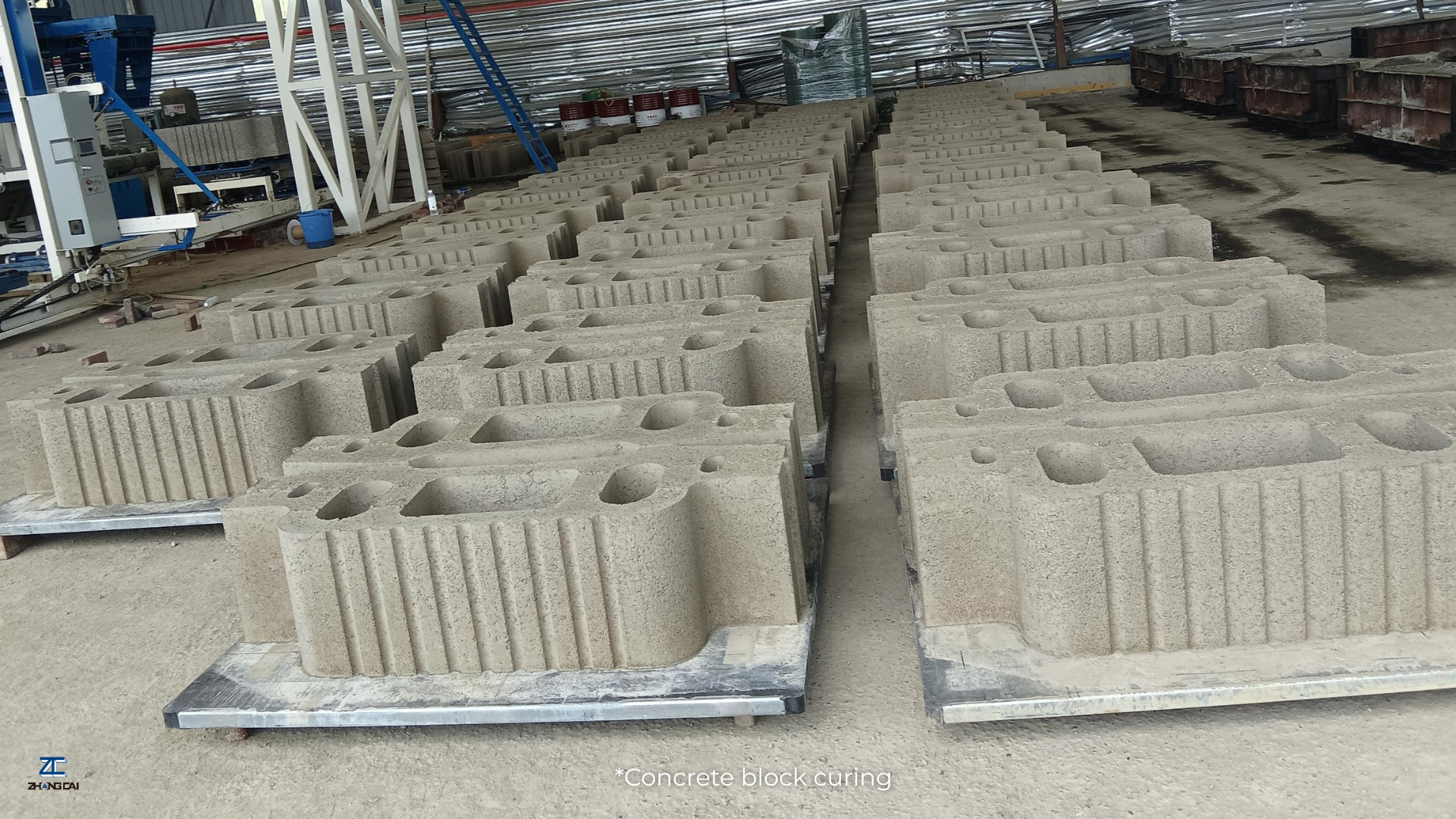

Curing capacity must accommodate the planned flow of green blocks for the required residence time. A first estimate is:
Active curing pallet positions = Pallet loads entering curing per day × Curing residence time in days
If 2,000 pallet loads enter curing daily and remain there for one day, approximately 2,000 pallet positions are needed for that stage. The footprint depends on rack levels, chamber design, aisles, handling equipment, and access requirements.
Set curing conditions according to the mix, product, process, and applicable standards. Central Asia has varied seasonal conditions: freezing weather may require protected curing, while hot or dry conditions can increase moisture-loss concerns. The American Concrete Institute explains that curing supports cement hydration and that temperature influences the process. Apply project-specific requirements rather than assuming one curing schedule fits every block and location.
Plan finished-goods storage separately from curing. Storage needs depend on dispatch frequency, order size, stacking practices, forklift access, and how much inventory the factory must hold when shipments are delayed.
Plan a logical flow:
Raw-material storage → Batching and mixing → Block forming → Green-block transfer → Curing → Finished-product storage → Dispatch
The arrangement depends on the site, equipment, curing method, and automation level.
Keep aggregate and cement supply accessible to the mixer. Place the forming machine, pallet feeding, and conveyors so fresh blocks can move toward curing without unnecessary transfers. Separate finished-product traffic from the main production route where possible, and reserve space for equipment maintenance, cleaning, and component replacement.
Consider expansion before construction. Future growth may require extra molds, mixing capacity, pallet handling, curing positions, or downstream automation. Check space, foundations, power, utilities, and material routes, and confirm upgrade compatibility with the manufacturer.
Before approving the configuration, confirm the following with your equipment supplier and engineering team:
- Products and output: Block types, dimensions, quality requirements, daily saleable target, shift hours, and mold-change frequency.
- Mixing: Actual concrete consumption, mixer discharge volume, complete batch cycle, and peak supply requirement.
- Pallets and handling: Blocks per pallet, daily pallet loads, circulation time, green-block transfer method, and allowance for operational variation.
- Curing and storage: Curing conditions and residence time, available pallet positions, finished-goods inventory, and seasonal site conditions.
- Layout and utilities: Material and forklift routes, access for maintenance, foundations, power supply, and potential expansion space.
- Commissioning: Installation requirements, operator training, quality checks, spare parts, and after-sales support.
Sharing these details early helps the manufacturer configure the complete system, not just quote the main machine.
A reliable concrete block production line depends on matching the forming machine with concrete supply, pallet circulation, handling, curing, and storage. For projects in Central Asia, production targets and site conditions should be assessed together before finalizing the equipment and layout.
ZCJK supplies block making machines, mixers, pallets, auxiliary equipment, and production-line solutions for different manufacturing requirements.
Contact us with your target block dimensions, expected daily output, available factory space, and automation requirements to discuss a suitable configuration.
What should I consider when planning a concrete block production line?
Consider machine capacity, mixing output, pallet circulation, green-block handling, curing space, finished-product storage, and future expansion needs.
How do I calculate the required capacity of a concrete block making machine?
Estimate output based on blocks per cycle, cycle time, and productive working hours. Then account for downtime, mold changes, product quality, and the capacity of supporting equipment.
Why is curing space important when planning a block production line?
Sufficient curing space prevents production bottlenecks by accommodating freshly formed blocks for the required curing period. The space needed depends on daily output, curing time, pallet capacity, and the curing system design.
