Introduction
Rising material, energy, and labor costs make production efficiency critical for concrete block manufacturers.
Instead of simply increasing machine speed, manufacturers should optimize feeding, vibration, hydraulics, automation, maintenance, and overall equipment effectiveness (OEE).
Here are 10 practical ways to improve concrete block machine efficiency and lower unit cost.
Pillar 1: Raw Material & Batching Control
1. Optimize Aggregate Grading and Mix Moisture
The efficiency of a concrete block machine depends not only on machine speed but also on the consistency of the mix. In semi-dry concrete block production, aggregate grading, cement content, and mix moisture should be properly balanced.
A well-graded aggregate mix improves particle packing, while consistent moisture helps the feed box fill molds evenly and supports effective vibration and compaction. Some specific hollow-block mixes use a water-cement ratio of 0.30–0.40, but this is not a universal setting. The appropriate moisture level depends on aggregate properties, cement content, admixtures, block geometry, and required green strength.
Manufacturers should optimize the mix through testing under actual production conditions. A properly designed mix can improve filling, compaction, block consistency, and material utilization, helping maintain stable production and avoid unnecessary cement consumption.
2. Ensure Continuous and Uniform Material Feeding
A high-capacity concrete block machine can still lose output when the mixer, feed hopper, and main machine are poorly synchronized. If concrete is unavailable when the machine is ready, the cycle becomes idle time.
Use a batching and mixing system that supplies a uniform mix continuously. Monitor hopper levels, mixing time, and transfer intervals so the feed box receives concrete at the required rate and distributes it evenly before compaction.
Related Reading:
What is a Concrete Batching System and How It Dictates Block Strength and Plant Profitability
Pillar 2: Molding & Vibration Technology

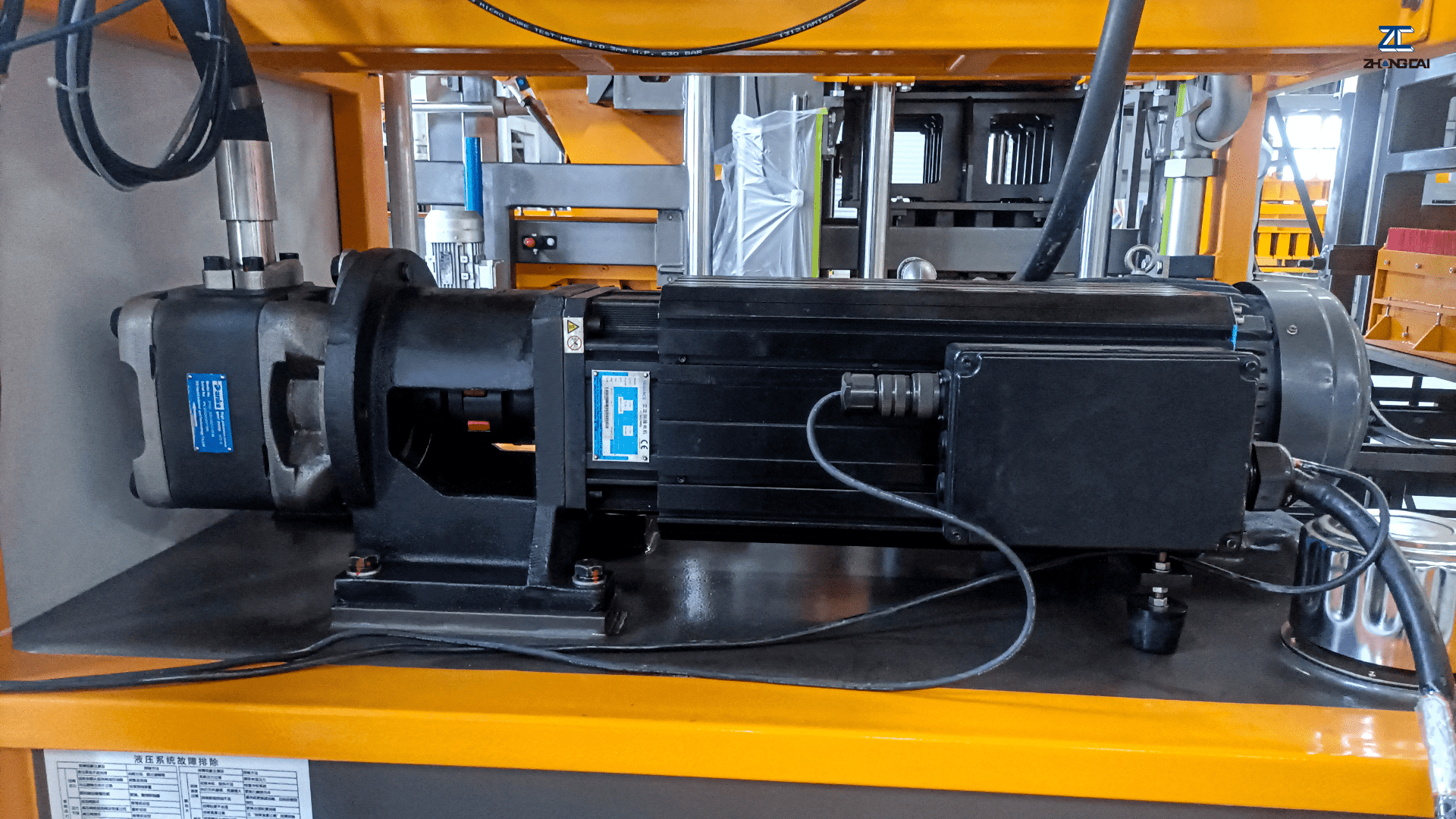

3. Optimize Vibration for Fast, Consistent Compaction
Vibration strongly affects cycle time, density, and surface quality, but more vibration does not automatically mean higher efficiency. Excessive or poorly timed vibration can waste energy and increase mechanical stress.
Servo-driven vibration systems can provide precise control of vibration intensity, timing, and response. Some high-output servo machines report cycle times of around 12–15 seconds, but actual performance varies with product type, mold configuration, mix, and machine design.
For ZCJK equipment, cycle time also varies by model and product. The QTY8-15 is listed at 15–25 seconds, while the ZC900, ZC1000, and ZC1200 are listed at approximately 12–22 seconds. Evaluate cycle time together with pieces per pallet, product type, and actual quality rather than using cycle time alone.
Related Reading:
How Servo-Driven Block Machines Reduce Cement Waste & Production Costs
4. Stabilize Hydraulic Response with Proportional Valves
Hydraulic response is critical in a hydraulic concrete block machine. Unstable pressure, excessive temperature variation, restricted flow, or poor valve adjustment can slow mold movement, pressing, and demolding.
Proportional valves allow pressure or flow to be regulated more precisely. ZCJK’s QTY8-15, for example, uses a dynamic proportional valve system.
Do not simply increase hydraulic pressure to make a machine faster. Check pressure stability, oil condition, cooling, valve response, seals, and cylinder movement against the manufacturer’s specifications.
Pillar 3: Automation & Changeover Efficiency

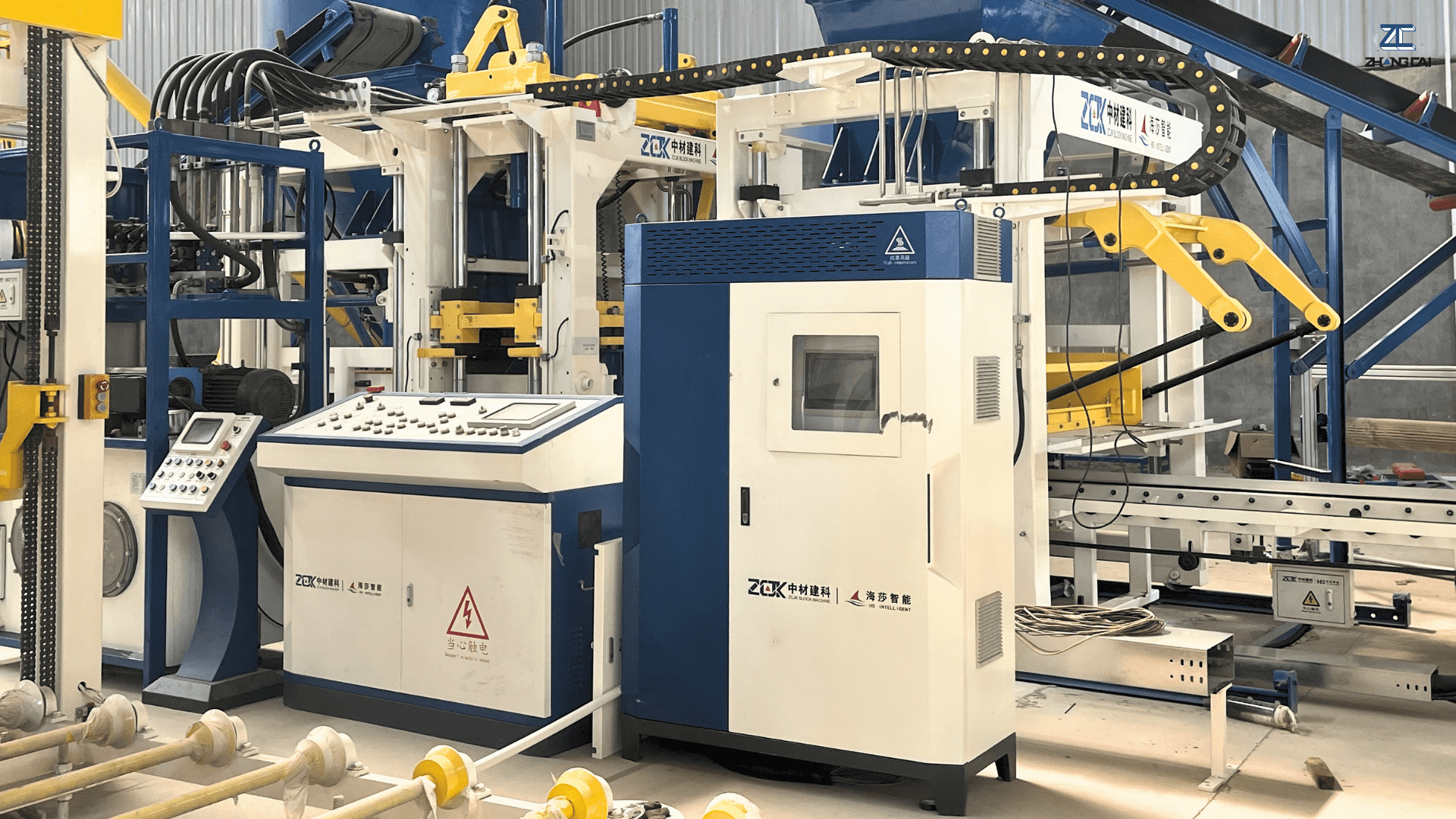

5. Integrate Intelligent PLC Systems and Remote Diagnostics
Automation reduces operator variation and keeps production sequences consistent. A PLC control system can coordinate feeding, molding, demolding, pallet movement, alarms, and interlocks while storing repeatable parameters.
ZCJK equips all the block making machines with corresponding PLC control cabinets, with configurations varying by model to support automatic and semi-automatic operation modes, as well as fault diagnosis and remote monitoring where applicable. Remote monitoring can help shorten troubleshooting time by allowing engineers to review machine conditions before an on-site visit.
Standardized recipes and parameter records also make product changeovers more repeatable when producing hollow blocks, solid bricks, pavers, or curbstones.
6. Reduce Mold Changeover Time
Mold changes are planned downtime, but preparation can reduce lost production time. Apply SMED principles by separating tasks requiring a stopped machine from tasks that can be prepared in advance.
Actual changeover time depends on mold weight, machine structure, clamping method, lifting equipment, and preparation. Quick-clamping devices, positioning guides, pre-staged tools, and prepared replacement molds can reduce non-productive time.
For higher automation levels, ZCJK offers block making machines equipped with automatic mold changing systems. Depending on the machine model and configuration, the system can streamline mold replacement and reduce manual handling, helping shorten changeover time and improve overall production efficiency.
7. Synchronize Line Logistics and Pallet Circulation
A fast main machine cannot deliver high daily output when downstream equipment is a bottleneck. Balance pallet feeding and cleaning, green-block conveying, curing-rack or finger-car operation, lowering, and automatic cubing or stacking.
Conveyor speed, buffer capacity, and transfer timing should match the molding cycle. If green blocks cannot leave quickly enough, the main machine may have to pause despite having a faster forming cycle.
Pillar 4: Preventive Maintenance & Operational Management
8. Execute Standardized Preventive Maintenance
Concrete block production exposes equipment to cement dust, aggregate particles, vibration, hydraulic pressure, and repeated movement. Preventive maintenance should be part of production management, not an emergency-only activity.
A practical program can include cleaning and visual inspection; scheduled lubrication and fastener checks; hydraulic oil, filter, hose, and seal inspections; and regular inspection of vibration components, guide columns, molds, electrical connections, and safety devices.
The exact interval should follow the manufacturer’s manual and actual operating conditions. There is no single maintenance interval for every hydraulic block machine because operating hours, dust exposure, oil condition, pressure cycles, and component condition vary.
9. Monitor OEE, Cycle Time, and Actual Output
You cannot improve production efficiency without measuring it.
OEE combines Availability, Performance, and Quality:
OEE = Availability × Performance × Quality
For cycle-time analysis, distinguish between ideal cycle time and actual average cycle time:
Actual Average Cycle Time = Net Operating Time ÷ Total Pallets Molded
Track cycle time by product, shift, mold, and machine. A rise from 18 to 21 seconds, for example, should trigger checks on feeding, vibration, hydraulics, sensors, mold condition, and minor stops.
An OEE of 85% is commonly cited as a world-class benchmark for discrete manufacturing, but it is not a universal target for every concrete block plant. Establish a reliable baseline and improve the largest loss categories first.
10. Establish SOPs and Train Operators
Even an automated block line depends on people for setup, inspection, replenishment, troubleshooting, cleaning, and maintenance. Standard Operating Procedures (SOPs) should define startup, material checks, changeover, alarm response, shutdown, cleaning, and routine inspections.
Training should cover abnormal vibration, uneven feeding, hydraulic instability, mold wear, unusual sounds, quality changes, and which parameters require maintenance or manufacturer support.
Standardized operating methods reduce shift-to-shift variation and turn individual experience into a repeatable production process.
Conclusion
Improving concrete block machine production efficiency is not simply about achieving the shortest cycle time. Consistent materials, stable molding and hydraulics, effective automation, line synchronization, maintenance, and operator skills all contribute to reliable production.
When choosing or upgrading equipment, consider product requirements, output, cycle time, automation level, maintenance needs, and total cost per saleable block.
ZCJK provides semi-automatic and fully automatic concrete block machine solutions for different production scales and product requirements. Contact us to discuss the right solution for your block production needs.
Frequently Asked Questions
Q1: What is the fastest way to reduce the cycle time of a concrete block machine?
A: Identify the slowest stage first. Check feeding, vibration/compaction, hydraulic movement, demolding, and pallet transfer separately. On suitable designs, optimizing vibration and hydraulic response can shorten cycle time without sacrificing quality.
Q2: How does raw material moisture affect concrete block production efficiency?
A: Moisture affects mold filling, compaction, green strength, and product consistency. Both too much and too little can cause problems. Set the level through mix design, aggregate moisture measurement, and production trials.
Q3: How often should block molds be cleaned and maintained?
A: Clean molds regularly, typically during end-of-shift housekeeping. Lubrication, fastener checks, guide components, hydraulics, and wear parts should follow the manufacturer’s schedule and operating conditions.
Q4: Can an automatic concrete block machine lower unit production costs?
A: It can by reducing labor dependency, stabilizing cycle times, improving material handling, and reducing rejects or idle time. Actual savings depend on configuration, local labor and energy costs, product mix, utilization, and maintenance.
Q5: What is a target OEE for a concrete block plant?
A: There is no single target for every plant. The widely cited 85% figure is a world-class discrete-manufacturing benchmark, not a universal concrete-block requirement. Establish a baseline and address the largest losses first.
